Tampere Tramway

To meet the needs of the growing city and urban area, a modern tramway  system has been designed for Tampere. The key goals of the tramway  system include making the everyday life and transportation easier  in the municipality, supporting the growth and development of the  urban area, and increasing the appeal of the city.

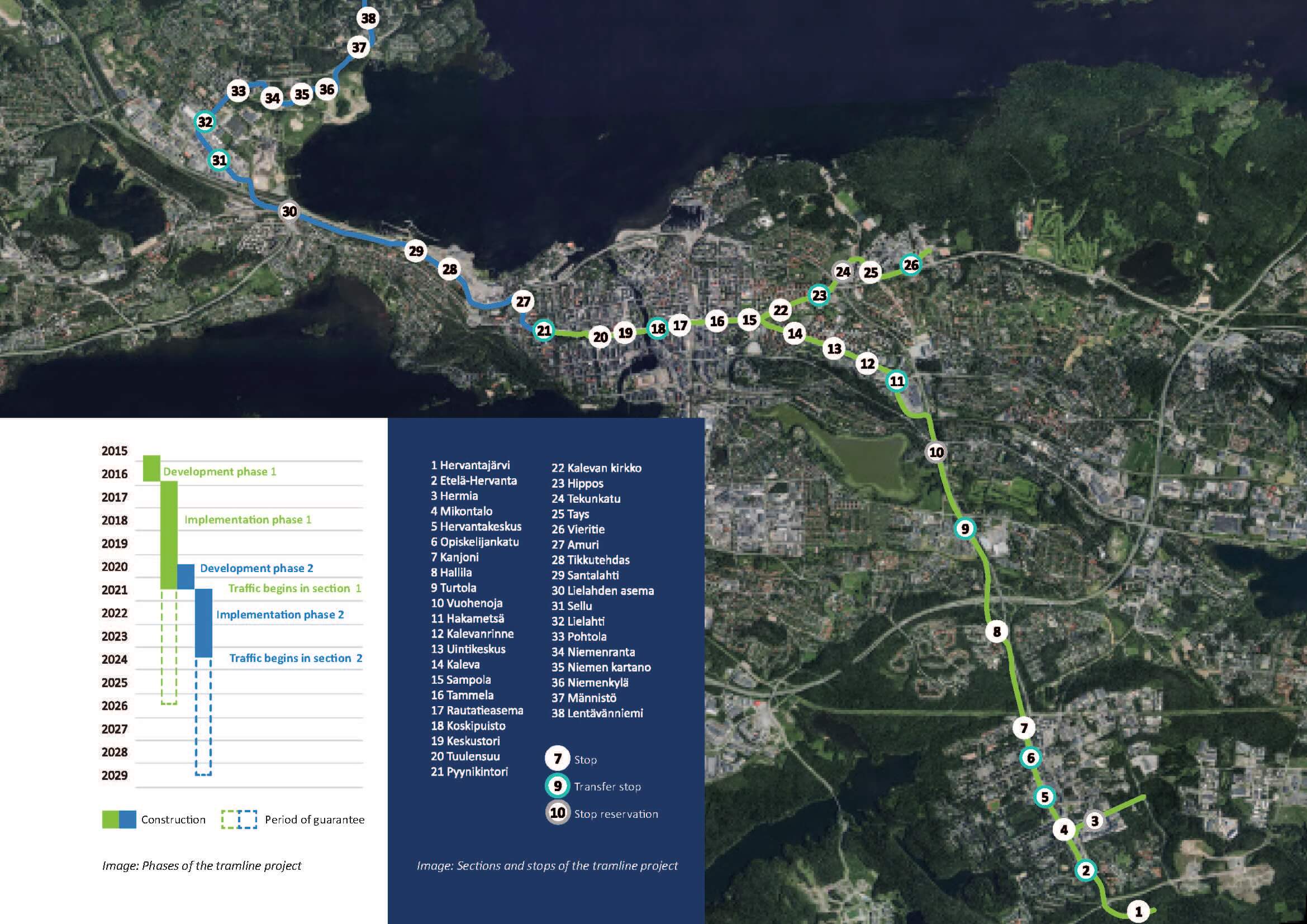

Sections and stops of the tramway project
Sections and stops of the tramway project

Current issues



The construction of the tramway has been divided into two sections.  Section 1 covers the construction of the eastbound two-branch line from Pyynikintori to Hervantajärvi and to Tampere University Hospital as well as the depot area in Hervanta. Section 2 covers the line westbound from Pyynikintori to Lentävänniemi via Lielahti.

The Tramway Alliance formed by the client, i.e. the City of Tampere,  and the service providers, i.e. YIT Construction Services, VR Track Oy and Pöyry Finland Oy, will be in charge of designing and constructing the tramway infrastructure and the depot area. The city will acquire the tram cars as a parallel procurement. Interfaces between the tram  car and the track have already been designed during the development phase, and coordination will continue to the implementation phase.

The Implementation content of the Alliance in section 1 includes the following taks:

  • construction of the tramway and the tramway stops
  • earthworks and roadwork required by the tramway
  • construction of the depot area and the power supply stations
  • the necessary lead and cable transfers
  • construction and alteration work of bridges and supporting wall structures
  • technical systems, including the overhead line, traffic lights, information networks, and surveillance and control systems

The Tramway Alliance has also drafted street designs on all the tramway  streets of section 1, with the exception of Hämeenkatu, the design of which the client will procure separately. The street designs depict the division of space on the streets in terms of traffic and functionality in the objective situation. In addition to the implementation content of the Alliance, the designs present other procedures to improve the quality of the street environment and alter the division of space in traffic. The City of Tampere will implement these changes to the street environment in accordance with the annual construction budget of common areas. Some of these procedures are already underway, and the rest will be carried out before, during or after the construction work of the tramway.

The construction of section 1 of the tramway will take about four years.  The construction work started during the spring 2017 on a number of sites: Hämeenkatu, Itsenäisyydenkatu, Sammonkatu, Hervannan Valtaväylä, Insinöörinkatu, Atomipolku, Hermiankatu and the depot area. The Alliance will be in charge of the design and implementation of traffic arrangements during the work as required by the construction of the tramway. Guaranteeing smooth and safe day-to-day travel to all means of transportation throughout the construction is the key principle between designing and optimising the phasing of the work.

The tramway will be adapted to the current urban environment. The values of the cityscape will be assessed particularly thoroughly in nationally significant cultural environments (RKY areas) that feature along the tramline in the city centre, Kaleva and Hervanta.

The progress and effects of the construction work will be communicated  openly and proactively. Public events, themed workshops and worksite visits, among other things, will be used to inspire active dialogue.

A total cost estimate, consisting of the objective cost that is binding to
all the parties of the Alliance, as well as the client’s procurements, the client’s risk reserve and the bonus pool, has been specified for section 1 of the Tramway Alliance. The cost estimate of section 2 has been specified for the route in accordance with the general plan as well as four optional routes in the Hiedanranta area. A binding objective cost for section 2 will be determined in the next development phase.

The total cost estimate for the construction of the infrastructure and the depot of the tramway when using the most cost-effective route via Hiedanranta is EUR 282.9 million, of which the share of section 1 is EUR 238.8 million and the share of section 2 is EUR 44.1 million.

The city will be in charge of operating the tramway, and the line will be accommodated as a part of the public transportation system of Tampere. The bus lines will be coordinated with the tram lines. The objective is to start the tramway traffic from the city centre to Hervanta and Tampere University Hospital in 2021.

Tracks of section 1 in numbers

  • Total length of the line tracks 15 km
  • Length of ballasted track 5,24 km
  • Length of slab track with a separate lane 5,87 km
  • Length of slab track with a mixed-traffic lane 3,89 km
  • Total length of depot tracks (one track) 2,80 km
  • Length of ballasted track 1,25 km
  • Length of indoor slab track 1,55 km
  • Width of tracks 1 435 mm
  • Number of power supply stations 10 pcs
  • Nominal voltage of drive power 750 Vdc
  • Number of rail switches 45 pcs
  • Number of rail switches along the tramline 30 pcs
  • Number of rail switches in the depot area 15 kpcs
  • Number of stops (+stop reserves) 23 (+3) pcs
  • Number of transfer stops 9 pcs
  • Length of a stop platform 47 m
  • Height of a stop platform (measured from the rail top) 35 cm
  • Number of new bridges to be constructed 7 pcs
  • Number of bridges to be renovated 9 pcs

Operation

  • Number of lines 2 pcs
  • Maximum speed 70 km/h
  • Running interval on weekdays in day 7,5 min
  • Operating hours on weekdays 4 a.m.–11 p.m.
  • Length of the Hervanta line 11,53 km
  • Length of the TAYS line 4,74 km
  • Length of the depot branch in Hermiankatu 0,99 km

Cars

  • Width of the car 2,65 m
  • Length of the car (optional increased length) 37 (47) m
  • Passenger capacity of the car 240
  • passengers
  • Number of cars 14 pcs
